Timeline

Excavation work began for The Carnelian in February 2022 as we went into the final stages of approval. We are following the RIBA Plan of Work; There are eight stages in the plan numbered from 0 to 7. We are currently at stage 5. Below is a summary of the key stages and our progress

.

2029
December 2029

11: Handover and Close Out

This phase focuses on the successful handover of the completed building, in line with the project program, and includes completing initial aftercare tasks.

November 2029

12: In Use

This involves a post-occupancy evaluation of the building to determine the project’s performance. It is also when facilities and asset management are implemented.

January 2029

9: Finishing

Doors, windows, sanitary, toiletry, flooring, kitchen, lighting, switches, sockets etc

2028
December 2028

10: Services & Comms

Services like power and water infrastructure, drainage, sewage and communication networks

January 2028

8: MEP, Fire & Saftey

Mechanical, electrical, plumbing, fire and safety fittings

2027
December 2027

7: Superstructure

Civil structure, basement floor to 21st floor, slabs, columns & walls

2026
May 2026

6: Substructure Stage

275 piles installations begins, pile integrity testing and pile load testing, pile cap installation and basement floor

2025
October 2025

5: Manufacturing & Construction Phase

This stage is when the actual process of building starts. This includes manufacturing building systems and erecting any components of the building that have been made off-site. During Stage 5, the designer should also carry out site inspections and compile quality reports.

September 2025

4: Technical Design

Stage 4 involves refining the architectural, building services, and structural engineering designs in greater detail. Technical designs will be developed. Designs by any specialist subcontractors will be completed.

August 2025

3: Spatial Coordination

The concept design will be further developed, and the architectural, building services, and structural engineering designs are coordinated and checked by the lead designer.

Construction Updates

In June 2021 we begin sourcing for the right contractors for the project.  The following have been done as outputs of phases one to four in our RIBA plan of work: Structural drawings, Architectural drawings, Mechanical & Electrical, fee payments required by federal ministries, 3D design visual guides, and Marketing Brochure. Squatters have also been evacuated from the area to ensure security and avoid future impediments. Whilst we await the necessary government approvals, we are fencing and creating our marketing billboard for the site. Stay current on the project progress with these construction updates.

By December 2022 we had begun pilling, built the shoreline protection however we had to halt the projects until July 2025 due to expansion of the great wall of Eko Atlantic City, uncertainty on the Lagos Calabar Coastal road due to erosion of land, loss of land either by the Ocean or from Federal Government in relation to allowed set back from the coastal road. We could not afford to continue to spend billions of Naira only to realise that our land is within the set back set by the Government.

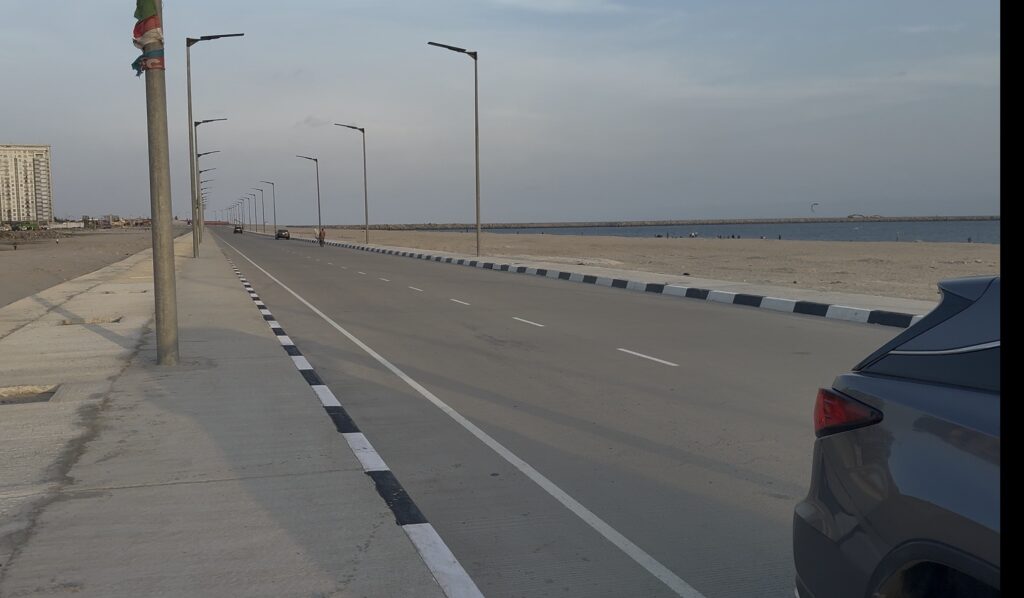

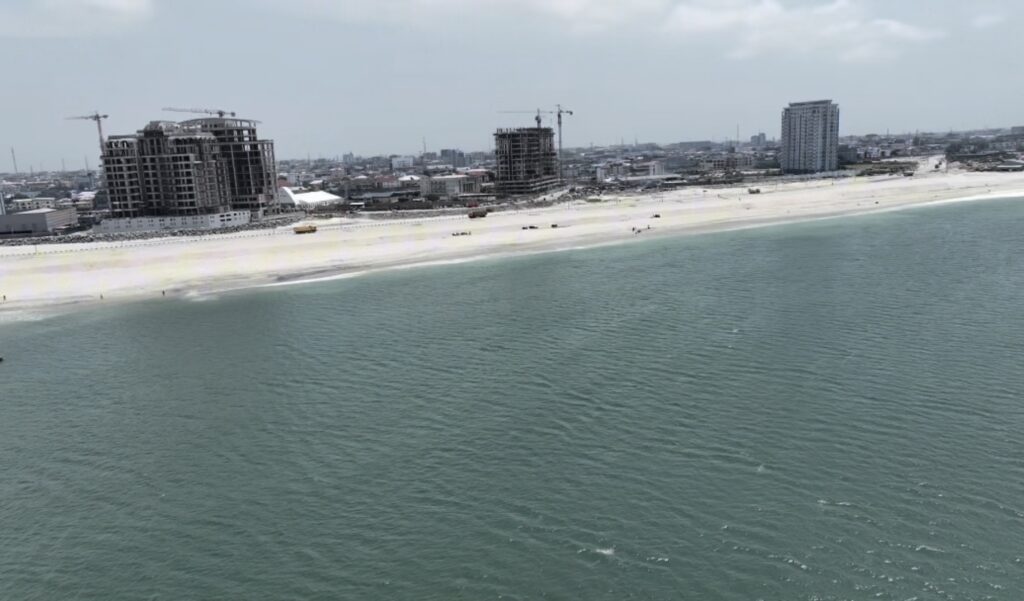

It’s July 2025, the Lagos Calabar road construction is completed pass Bluewater Okunde Tourism Zone, where we are, set back is defined by Federal as 90m, we are outside the set back, Eko Atlantic Resort & Beach is clearly visible as we overlook both the coastal road and the beach. We secure approval to continue to build and we begin pilling again.

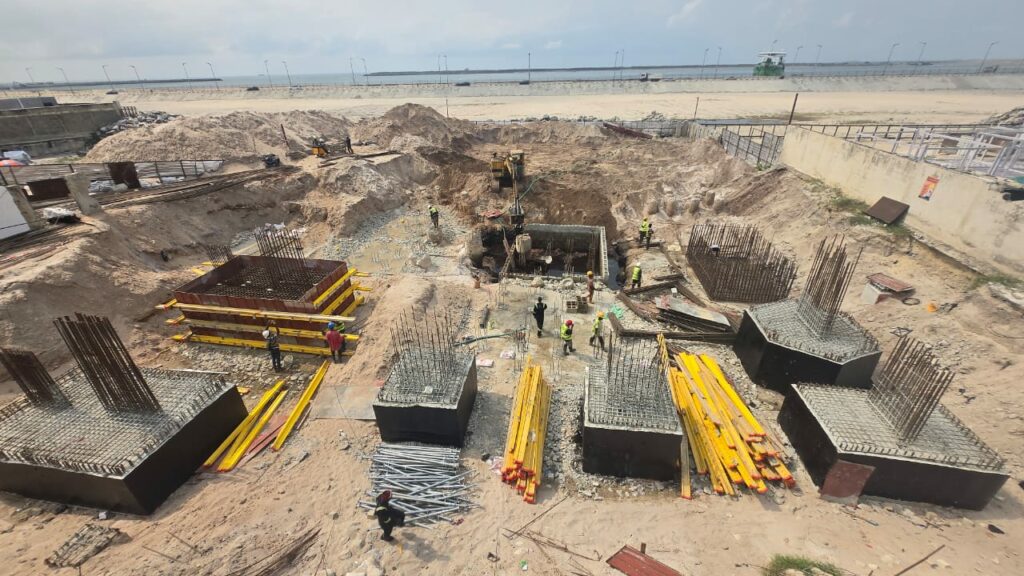

By Feb 2026, 275 piles installed, we carry out integrity and load testing, we begin pile caps and now moving up to basement floor.

Progress In Pictures

Follow us on the journey to building the iconic Carnelian Tower, from initial land inspection to the final touches during interior decor and furnishing, we will share every step of the journey.
